Shipping from Dung Quat Port: project cargo, freight and vessel operations
Published
For a shipment from Dung Quat, SVC Marine examines the cargo and both terminals, negotiates suitable vessel and freight terms, and undertakes the port-captaincy, lifting, lashing or technical work actually appointed to us. One completed Dung Quat lashing job is described separately; the wider shipping scopes below are services to discuss for a new shipment.
01
Begin with cargo, terminal and readiness
Send SVC the cargo description, packing list, unit dimensions and gross weights, maximum single lift, exact loading berth or site, discharge terminal and ready date. For a project unit, include drawings, lifting points, centre of gravity if known, photographs and any proposed stowage arrangement. We compare these particulars before approaching tonnage or quoting the vessel-side work.
A factory or yard address in Quang Ngai is not a confirmed loading berth. Cargo may first need road transfer, storage or a separate barge movement. SVC asks where the units are physically ready, who controls site access and which loading method is available. Email the worklist to shipping@
02
Dung Quat and Quang Ngai loading locations
Dung Quat Port, nearby industrial sites, fabrication yards and shipyards can produce very different cargo and handling conditions. SVC checks the named terminal or anchorage, permitted vessel position, draft, berth window, shore-crane access and the route from cargo storage to ship side. The agent or terminal must confirm its own permissions and actual facilities.
For a new assignment we establish which party presents cargo alongside, who supplies stevedores and cranes, and whether loading occurs at a berth or through a barge or anchorage operation. We do not assume that every industrial site has direct port access or that any crane is permanently available.
- Named terminal, berth, anchorage or cargo collection point and site access rules
- Cargo readiness, stacking area and movement to the loading position
- Vessel draft, berth window, gear, shore equipment and weather limits to verify locally
- Discharge-port berth, crane, storage and delivery requirements
03
The cargoes and protection they require
SVC examines project units, industrial machinery, fabricated modules, structural steel, port and shipyard equipment, construction materials, packed general cargo, jumbo bags and suitable bulk parcels from the Dung Quat area.
A long welded module needs different lifting and bearing arrangements from bundled steel or moisture-sensitive bagged cargo. We check packing, individual weights, lifting and contact points, exposure limits, unit count and destination handling before selecting a shipment method. The project cargo shipping guide explains drawings and handling particulars in more detail.
- Modules, machinery and heavy equipment: individual lifts and lifting-point evidence
- Steel plates, profiles and fabricated members: separation, rolling and contact protection
- Crates, pallets, jumbo bags or suitable bulk cargo: packing strength, volume and cargo care
- Marine, port, shipyard and offshore-related equipment: loading envelope and discharge capability
04
Choose a shipment method before fixing the vessel
SVC compares container service, flat racks or open tops for workable units with general-cargo, breakbulk, multipurpose, part-cargo and dedicated voyage-charter options. A container service can suit regular or smaller lots only if out-of-gauge acceptance, handling and routing work at both ends. Larger pieces or mixed heavy units may require geared tonnage or an agreed shore-crane plan.
The decision uses the heaviest unit, total weight and volume, cargo density, hatch openings, hold or deck space, securing points, loading sequence and discharge equipment. Part cargo can reduce the freight commitment if the vessel remains suitable and the laycan and stowage restrictions are clear. A dedicated charter offers a different schedule and cost allocation. SVC negotiates the appointed option against the actual handling plan, not freight rate alone.
- Container, flat rack or open top where dimensions, service and terminal handling permit
- General cargo or multipurpose vessel for breakbulk and mixed project units
- Suitable part-cargo space when stowage and schedule can be agreed
- Voyage charter or larger bulk tonnage for an appropriate dedicated cargo stem
05
Check vessel suitability at both ports
For general-cargo, geared, multipurpose, heavy-lift-capable, mini-bulk or larger bulk vessels, SVC checks cargo capacity and hold or deck geometry against the real cargo. The maximum unit must pass through the hatch and be lifted at the required radius; a nominal crane rating alone does not prove that the operation works. Draft, berth limits, lifting gear condition and discharge equipment matter at both ends.
Before an appointed fixture, we compare the vessel particulars, cargo-space plan and loading sequence with the charter and port requirements. If ship gear is essential, the owner or operator must provide its current gear records and operational condition for review. A low freight quotation can become costly when unsuitable gear, draft or discharge arrangements delay the ship. See vessel chartering services for the commercial worklist.
- Quantity, stowage factor, volume, maximum single unit and hold/deck location
- Hatch clearances, crane safe working load at working radius and lifting sequence
- Draft, berth restrictions, shore equipment and destination discharge method
- Cargo securing points, weather exposure and the agreed charter window
06
Plan heavy and oversized lifts from the unit drawing
A heavy machine or fabricated unit should be assessed by its actual weight, footprint, lifting points and centre of gravity. SVC reads the drawings and cargo photographs, defines the work requested from our crew or port captain, and identifies where the lifting contractor, master or surveyor must confirm the lifting plan. We distinguish the appointed attendance from any engineering calculation or certification that has not been commissioned.
The handling proposal records whether a ship crane, shore crane or floating crane can make the lift; how the unit reaches the hook; the planned landing and stowage position; and the discharge method. It also identifies slings, spreaders, lift points, bearing areas, dunnage and any separate survey requirement. Loading and discharge must both work before SVC negotiates a vessel option. The heavy equipment shipping service covers the wider method.
- Maximum individual lift, gross weight, centre of gravity and lifting-point information
- Crane capacity and outreach, rigging, route to ship side and landing sequence
- Hold or deck bearing, access, dunnage, chocking and discharge equipment
- Responsible engineer, master or chief officer, and surveyor review where required
07
Protect steel, fabricated structures and industrial equipment
Steel bundles, plates and fabricated frames can shift, roll or damage each other when their bearing and contact points are poorly arranged. SVC checks unit size, bundle or crate condition, separation, dunnage and the intended hold or deck stowage against the appointed cargo-care worklist. Rust, rain, seawater exposure and contamination are considered before the loading method is agreed.
A steel shipment may fit a breakbulk vessel, multipurpose vessel, flat rack or dedicated charter. We compare how each option handles the longest member and largest unit, where cargo will wait before loading, who supplies protection materials, and how the destination will discharge and store it. The steel and equipment shipping page sets out the broader shipment scope.
- Bundle, crate or loose-unit packing, gross weight and dimensional spread
- Rolling or contact damage, bearing and separation, dunnage and chocking
- Rust, moisture, rain, seawater and contamination exposure
- Deck or hold position, securing responsibility and destination handling
08

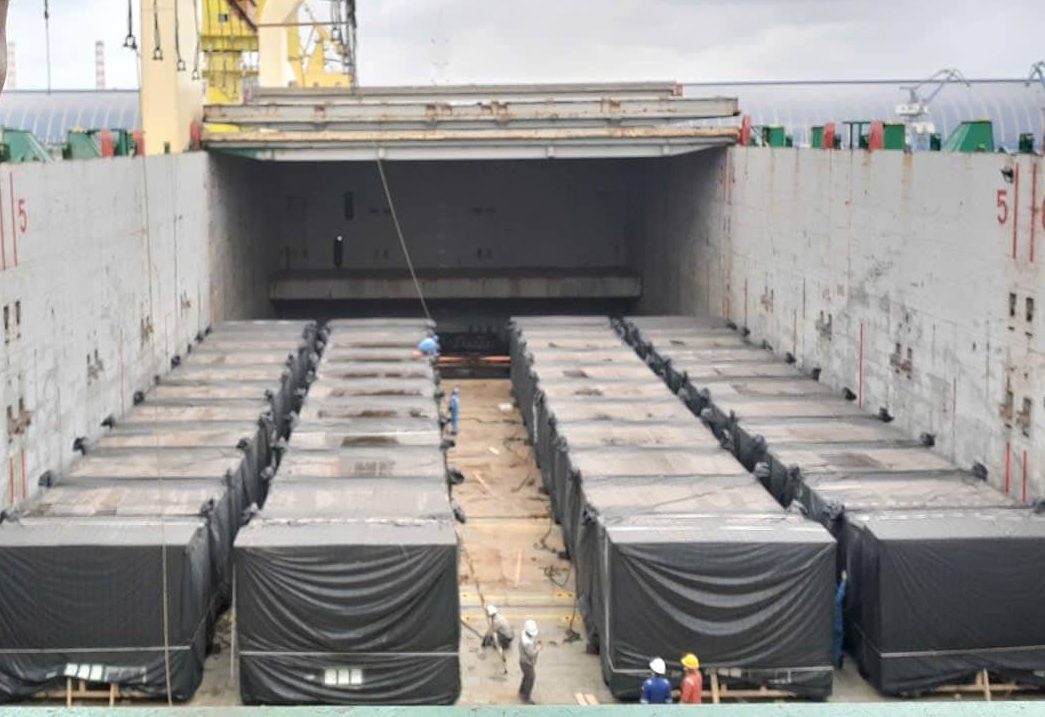

SVC lashing work: a completed Dung Quat assignment
On one documented project-cargo assignment at Dung Quat, SVC assigned its local crew, reviewed the cargo particulars and photographs, performed the appointed lashing work and kept work-status records. The Dung Quat lashing case study describes that job.
For a new shipment our crew can undertake the agreed dunnage, chocking, chains, wires and securing fittings; welders can perform a separately commissioned welded securing scope where required and permitted. We first need cargo weights, centre of gravity, base footprint, stowage position, available securing points and the vessel access window. The master and any appointed surveyor retain their own review roles. See the cargo lashing service for materials and attendance details.
- Unit bearing and contact area, restraint direction and securing-point availability
- Dunnage, chocking, chain, wire, shackle and turnbuckle work actually commissioned
- Separate welded fastening, hot-work permission or survey scope when applicable
- Photographs and attendance records for the completed appointed work
09
Floating crane and barge transfer
A heavy lift, unavailable berth, unsuitable shore crane or failed ship crane can change the loading method. SVC examines a floating-crane or barge-transfer proposal only for the actual cargo site and working window. We compare the maximum lift, crane capacity at outreach, vessel position, barge rotation, weather and the securing work after loading. Port and anchorage permissions must be confirmed by the responsible authority or agent.
If cargo gear develops a fault, our technical team may inspect and undertake a separately commissioned repair. SVC sets the vessel-side communication plan with the master, agent, crane operator and cargo party for the appointed operation. Crane hire, barges, vessel-gear repair, port-captain attendance and cargo securing are separate work and cost lines. The cargo owner and vessel parties decide the revised loading method. See floating crane arrangement in Vietnam for the inputs needed to examine that option.
- Crane availability, lift capacity at working radius and rigging method
- Barge capacity, rotation, stability inputs and transfer sequence
- Weather, vessel position, port permission and appointed safety roles
- Post-lift stowage and lashing, with a distinct gear-repair scope if needed
10
Port captaincy and loading records
When appointed, an SVC port captain attends the cargo operation, compares cargo particulars with the proposed sequence, observes handling and records progress, interruptions and apparent cargo condition. The master controls the vessel and the terminal controls its operation; SVC reports a mismatch or unsafe condition for the responsible party to resolve before work proceeds.
The agreed file may contain cargo photographs, tally or survey references, work attendance, weather interruptions and a record of completed lashing or technical tasks. We define the particular deliverables in the quotation; a port-captain visit is not an automatic survey certificate or an approval of cargo engineering.
11
Negotiate the whole loading and discharge cost
SVC negotiates the freight, laycan and charter terms we are appointed to handle. We put the cargo quantity, loading and discharge rate, ship gear, crane, stevedore, dunnage, lashing, tally, survey and port costs into the same commercial discussion. The freight number alone does not say who pays for a floating crane, waiting time or a later change in cargo readiness.
FIOS generally places loading, discharge and stowage outside the freight; FILO places loading outside and discharge on liner terms. Liner in/liner out is another allocation. The precise charter or booking wording governs, so SVC counters ambiguous terms clause by clause with the parties before fixture. We examine weather-working days, allowed laytime, demurrage and despatch, and who pays for waiting or lost time. Customs and documentation remain with the party named in the agreed trade terms.
- FIOS, FILO or liner allocations and the actual named cargo work
- Shore crane, ship gear, floating crane, stevedores and barge movement
- Dunnage, lashing, tally, survey, documentation and port charges
- Laycan, loading/discharge rate, weather days, demurrage and despatch
12
Resolve operational risks before vessel fixture
SVC checks the proposed operation for the mismatch most likely to delay or damage the cargo: wrong vessel dimensions, incomplete unit weights, unsuitable hatch or crane reach, draft or berth restrictions, missing lifting points, uncertain lashing materials and a discharge port that cannot handle the largest unit. We ask the responsible parties to settle those conditions before cargo is delivered or a vessel is fixed.
Steel and machinery also need protection from moisture, rust, rolling and contact damage. A vague loading-responsibility split can cause waiting time and demurrage. We compare cargo declarations, packing figures and shipping instructions early so document differences are found before the bill of lading is issued.
- Vessel, hold, hatch, draft or berth mismatch
- Insufficient gear or shore-crane capacity and missing lift information
- Cargo shifting, exposure, contamination or inadequate securing
- Unclear work responsibility, weather window, waiting time and documents
13
Check cargo and shipping documents
The cargo owner supplies accurate declarations and the lawful export or destination papers. Within its appointed scope SVC checks the packing list, shipping instructions and bill-of-lading draft against the cargo dimensions, unit count, weights, marks and agreed commercial terms, then identifies mismatches for the responsible issuer to correct.
The required document set depends on cargo, buyer and destination. It may include a commercial invoice, certificate of origin, product specification or MSDS, phytosanitary or fumigation certificate where relevant, quality or weight certificate, customs papers, survey or tally report, lifting drawing and cargo photographs. We name the party that produces each record in the shipment worklist; statutory certificates are issued by the authorised body.
- Commercial invoice, packing list, marks, weight and certificate of origin where required
- Product specification or MSDS, phytosanitary, fumigation, quality or weight records as applicable
- Cargo drawing, lifting plan, survey or tally records for relevant project units
- Shipping instructions, bill-of-lading draft and required export or destination documents
14
A working sequence for the appointed shipment
SVC starts with the cargo file and exact locations, compares feasible shipment methods and tonnage, then negotiates the appointed freight and operating terms. Before fixture or booking, the loading and discharge parties confirm the berth, gear, crane, stowage and cargo-care responsibilities. The proposal says which work SVC will perform itself and which records come from the owner, agent, terminal or surveyor.
Once appointed to vessel-side work, our people attend the agreed window, carry out their port-captain, lashing or technical tasks and record what was done. Any departure from cargo particulars or planned equipment goes back to the decision maker before the operation changes. We check the completed work record and shipping documents against the agreed deliverables.
- Review cargo and both locations; compare container, breakbulk and charter options
- Check vessel and handling feasibility; negotiate freight and work allocation
- Set the appointed site attendance, materials, permissions and records
- Execute commissioned work and record completion against the worklist
15
Information for a Dung Quat freight and work quotation
Put the cargo data, trade terms and physical operation into a single enquiry. An indicative target budget helps compare a container, part-cargo or dedicated fixture, but is not a substitute for unit weights, terminal conditions or the discharge method. Name the shipper, consignee and notify party where the trade and documentation require them.
If SVC is to quote a port captain, lashing crew, crane, gear repair or survey attendance, mark each separately and state the requested output: photographs, attendance record, tally, repair scope or other document. Send the file to shipping@
- Cargo name, quantity, packing, individual dimensions, weights and maximum lift
- Lifting points, centre of gravity, photographs and drawings where available
- Exact loading site and discharge terminal; readiness date and desired laycan
- Loading and discharge cost terms; gear, crane, securing, survey and tally needs
- Target freight budget; shipper, consignee and notify party where applicable
- Requested SVC field tasks, material supply and completion records
16
Routes and related work
A Dung Quat quotation begins with the exact discharge terminal rather than a broad region. SVC can examine a suitable domestic or international route once cargo, vessel and destination conditions are known. The Vietnam-to-China shipping page explains that specific route; Vung Ang shipping covers another loading area. Neither page promises a completed voyage or permanent vessel availability.
For a project shipment, use the project cargo guide, vessel chartering service and cargo lashing service for the corresponding work. Send one coherent cargo file rather than assuming that a vessel fixture also includes a crane, port captain or lashing crew.
17
Questions about shipping from Dung Quat
Does SVC Marine undertake shipping enquiries from Dung Quat Port?
Yes. SVC examines cargo from the named Dung Quat or Quang Ngai loading location, compares feasible vessel and freight options, and quotes the port or cargo tasks appointed to us. The vessel, berth and crew plan depend on actual cargo, access and availability.
Can SVC find and negotiate a vessel from Dung Quat?
SVC reviews dimensions, total weight and volume, largest unit, terminal limits, discharge handling and readiness. We then approach suitable general-cargo, multipurpose, part-cargo, bulk or charter tonnage and negotiate the appointed freight and operating terms before a fixture decision.
What cargo details are required for a Dung Quat freight quotation?
Provide cargo name, quantity, packing, unit dimensions and weights, maximum single lift, exact loading and discharge terminals, readiness date, loading and discharge cost terms, gear or crane needs, securing work, photographs and drawings. Add target budget and trade-party details where applicable.
Does SVC carry out lashing and securing at Dung Quat?
SVC performed one documented Dung Quat lashing assignment. For another shipment our crew can quote the appointed securing materials and work against cargo weight, stowage position, securing points, vessel access and team availability. Welded fastening or engineering approval is a separate scope.
Can a floating crane or barge transfer be included?
Yes, when the particular cargo and port conditions call for it. Send the maximum lift, site, vessel gear, working window and proposed transfer. SVC examines crane outreach and availability, barge sequence, permissions and weather, then quotes any appointed operation separately from freight and lashing.
Describe the Dung Quat cargo and loading work
Send the packing list, unit weights and drawings, largest lift, exact cargo site and discharge terminal, readiness date and proposed freight terms. Mark the vessel, crane, port-captain or lashing work you need SVC to undertake.
